Business Intelligence Begins with Project Management

Whether your business intelligence tools will provide any actual intelligence is determined long before the need to report on status. The difference between a tool that repeats what you already know and one that tells you what you should be doing is a function of project management.

This runs against how most organizations think about business intelligence. When clients say they need a dashboard, the request is usually read as a call for a data-analytics-and-visualization product—a dashboard, a tracker, a report—built sometime after the project starts to read out the state of the engagement. Intelligence is assumed to live in the visualization of the data, even when that visualization shows little more than the pivot tables that came before it. But intelligence doesn’t come from KPIs, and it can’t be extracted from individuals reporting out a RAG status.

When BI requires a new build every reporting cycle or depends on connections to sources disconnected from the work it’s meant to capture, the instinct is to fix the build. That instinct reveals an underlying assumption: the field of data analytics and visualization is ultimately separate from the discipline of project management. PM controls the work; BI is a layer stood up later to report on it. This seems intuitively correct, but it fails in practice at scale and under complexity. The single most important factor in whether BI tools are intelligent is set upstream, when the work is first decomposed into a project plan. To understand why, we must first understand what we mean by “intelligence.”

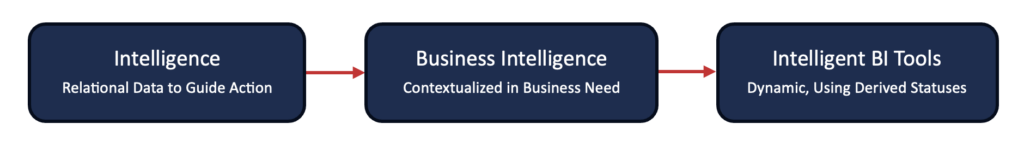

Business Intelligence, as first defined in 1958, centered on the interrelationships among facts, “…in such a way as to guide action towards a desired goal” (Luhn, 1958, IBM). Modern definitions emphasize the tools of BI—modeling, analysis, and data visualization—but maintain that the objective of these is “to support informed decision making and value creation” (Gartner Peer Insights, 2026). In other words, data alone isn’t sufficiently intelligent. In a business context, a relational element is required—one that moves beyond “where are we?” toward “what should I do?”

The connection to project management becomes visible when you examine the most common visualization in any report: status. For a BI tool to actually be intelligent — not just appear intelligent — the data feeding it must be trustworthy and structurally sound. The tool may seem intelligent, but how can we be sure? We can examine this by looking at status itself.

Of the many ways that one can indicate the performance of any piece of work, there are two main classes: assigned status and derived status.

  • Assigned status is a judgment of performance based on individual knowledge and recorded as a metric. This is essentially an opinion, which can be challenged only by a competing opinion. Variations of this method include RAG and narrative statuses, confidence polling or surveys, and executive judgement.
  • Derived status is a calculated read-out of underlying data, based on business rules. In project and program management, Earned Value Management (EVM) provides a method for calculating project performance – combining scope, time, and cost measurements to predict project success.

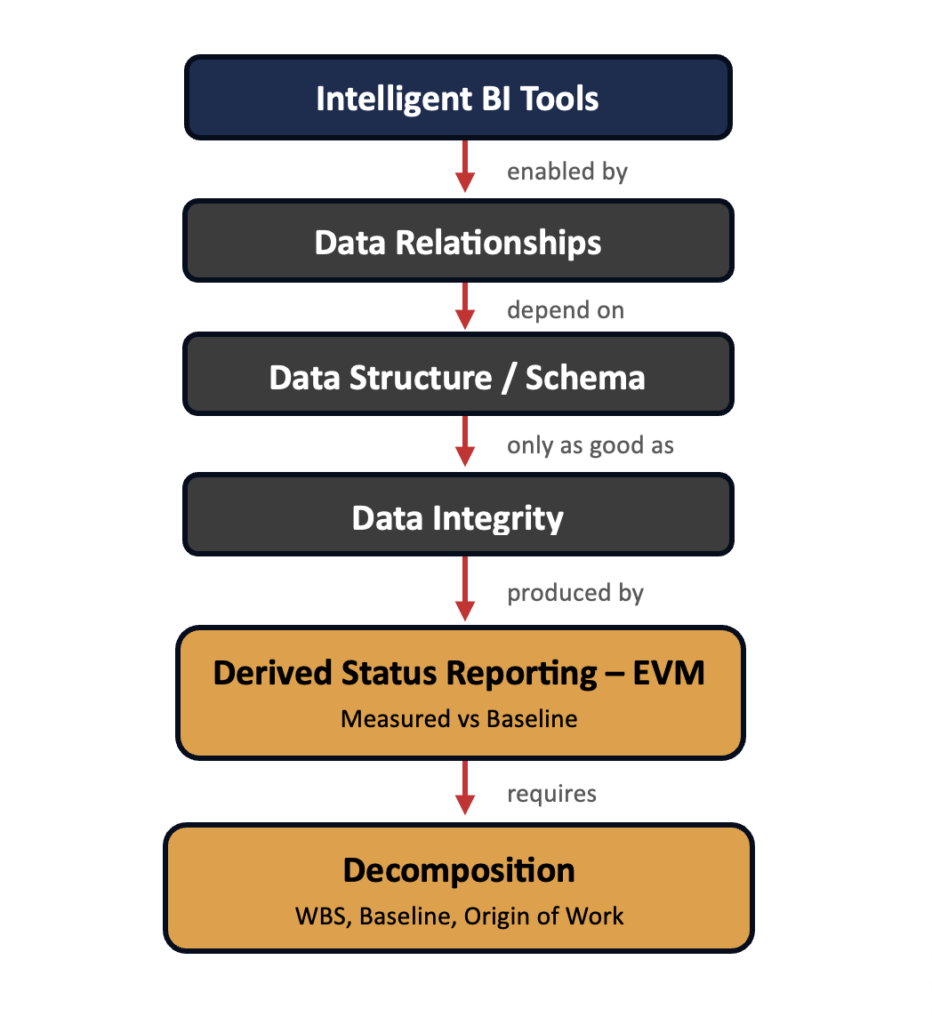

The enabling condition of intelligent BI tools requires that data is organized so that it can be stacked together to create insights, reporting, and status. This is only consistently achievable through derived status, and it is a function of how projects are structured from the beginning, not a function of data visualization and analytics.

A misconception of derived status is that it requires tedious capture of performance data. In fact, EVM metrics require only the capture of whether planned work has been completed—and when. This is achieved by decomposition of work following a set of fundamental principles:

  • Entity Separation: deliverables, activities, risks, issues, and dependencies exist as distinct, addressable objects
  • Relational Association: every object is tied to the work it affects — a risk to the activities it threatens, an issue to its deliverable
  • Hierarchical Coherence: dates, ownership, and scope reconcile across levels, so a milestone’s date squares with every activity beneath it
  • Business Rules: the logic encoding what “on track” and “at risk” actually mean, grounded in EVM metrics

By the time anyone asks for a dashboard, every layer above was determined by the ones before. Intelligent business intelligence is a consequence considering project management principles at the start, at little additional cost to good PM practice on its own.

So, when the call next comes to create a dashboard, start by reviewing the project plan.
